3.4  Construction Management

In construction management, the principal engages a construction manager (contractor or consultant) to manage construction works on its behalf.  The principal manages the scoping and engages the designer directly. The principal also engages the trade contractors directly, although these contracts are entered into by the construction manager as the principal's agent. The construction manager performs a purely management and co-ordination role (without delivery risk) and is generally paid a fee based on a percentage of the value of the works.

The following figure illustrates the contractual relationships involved in a typical construction management arrangement -

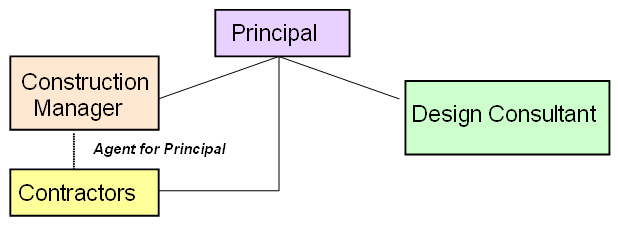

Figure 7: Construction Management Structure

The construction manager typically:

 provides advice, coordination, planning, cost management, supervision;

 is paid a fee based on time or a percentage of the value of the works;

 engages trade contractors as agent for the client;

 is responsible for preliminaries for those trade contractors (e.g. crane hire, site sheds etc); and

 does not take any cost risk or design risk although the construction manager may be paid to assist the client with cost control and design advice.

Construction management sometimes appears similar to the managing contractor model. Some key differences between the models are shown in the following table -

Element

Construction Management

Managing Contractor

Cost risk

The construction manager does not typically assume cost risk

The managing contractor

 assumes cost risk

 typically guarantees a maximum price for the works and

 receives incentive payments for achieving cost targets

Cost certainty

The principal has little cost certainty until all of the trade contracts are in place and will need to closely manage those contracts to control costs

The principal usually has cost certainty through the guaranteed maximum price

Remuneration

The construction manager is usually paid a fee based on time or a percentage of the value of the works

A fixed lump sum management fee is usually negotiated.  The managing contractor may also receive incentive payments for achieving cost and schedule targets.

Design risk

The construction manager may provide some design advice but does not accept overall design risk

The managing contractor accepts design risk

The construction management model can be suitable for major construction in particular situations e.g.:

 If a contractor collapsed mid-project, it may be more efficient to complete the project through construction management than to fully document and tender the balance of the works as a single package;

 where government needs to retain direct control over works e.g. in an operating hospital or rail corridor; and/or

 complex projects where it is not possible for design of some elements to be started before work is undertaken on others.

The following table lists features of the construction management model -

Advantages

Disadvantages (and issues that may need managing)

 Construction manager administers contractors on principal's behalf

 The principal selects its own architect/design consultants

 The principal can shift management risk to the construction manager

 The principal can retain a high degree of control over works while engaging an expert professional to administer and coordinate the project

 Parts of a project can proceed while other aspects are still being documented

 No single line of responsibility

 The principal must claim directly against the contractors & consultants if things go wrong

 Can be administratively complicated

 Extra cost of construction manager

 Limited ability of principal to control costs

 No cost certainty

 Lack of focus on lifecycle costs and considerations
